Transportation & Infrastructure

Construction

Construction of the 4.5km rail spur line from the TSH mainline to the Silver Yard loading facility and beneficiation plant for the James mine commenced May 4, 2010 and was completed in early June. The first iron ore train left the Silver Yard processing plant and loading area on June 29, 2011.

In September 2010, site preparation and construction commenced on the process plant at the Silver Yard and for the accommodation camp at Bean Lake. Today these stand completed with the first phase of the plant having been commissioned.

First Ore Train


First Ore Train Leaves Silver Yard - June 29, 2011

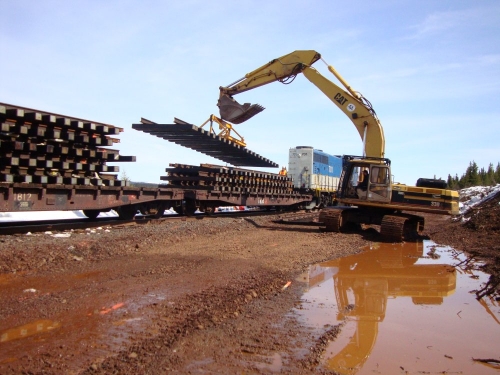

Track panels were constructed in 40 foot lengths at LIM's Centre Ferro facility in Sept-Iles and transported by rail to the spur line site for immediate installation.

Railway 3 - track panels

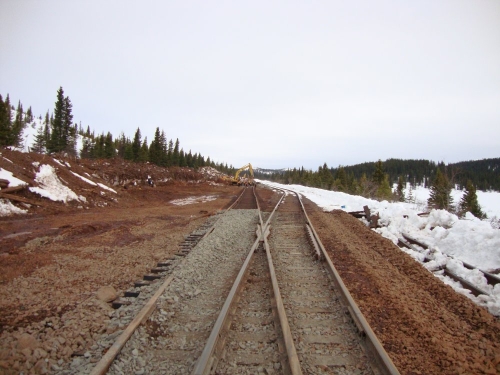

Laying of Track Panels

The spur line railway follows an existing rail bed used during the time of the Iron Ore Company of Canada operations. Additional road bed ballast is being added using air dump cars. Railway 4 - air dump ballast cars

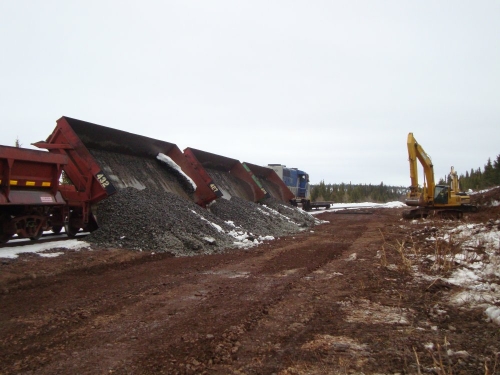

Air Dump Ballast Cars

Existing Local Infrastructure

Infrastructure - All

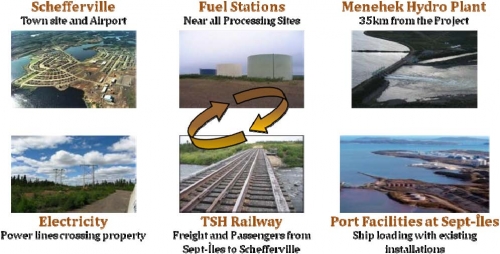

The project benefits from and relies upon the significant level of pre-existing infrastructure put in place by the Iron Ore Company of Canada (IOC) for its previous mining operations. It is the existence of extensive infrastructure facilities, the majority of which are in sound operational condition, that provide LIM with a strong competitive advantage and low risk start-up. It will also ensure that new build facilities will be kept to a minimum so as to limit the impact of the project on both the physical and the social environments.

Infrastructure - Schefferville

  • Access roads
  • Hydro-electric power
  • 565km railway link
  • Deep port facilities
  • Town site and Airport
  • Town of Schefferville

    The town of Schefferville, Quebec is located approximately 2 km from the Labrador border on the north shore of Knob Lake. The town was established by IOC in 1954 to support mining operations in the area and economic activity there has been largely dependent on the iron ore industry. The township provides some key infrastructure including roadways, power and water supply, buildings and sewage facilities, as well as an airport which has daily flights from Montreal, Quebec and Sept-Iles.

    Menihek Hydro Plant

    Infrastructure - Menehek

    The Menihek power plant located 35km southeast of Schefferville is the only provider of electric power to the area. The power plant contains two 5 MW Westinghouse generators and one 12 MW unit, sufficient to supply the power that LIM would require for the early development sites close to Schefferville (James, Knob Lake and Redmond).

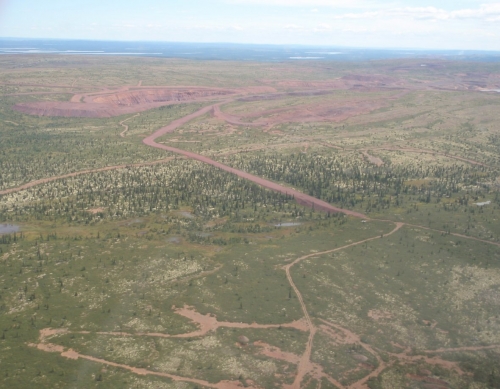

    Roads

    Most of the roads that provide access to the different properties designated for early development (James, Houston, Knob Lake and Redmond) already exist and require minimal upgrade.

    Infrastructure - Roads

    The Railway

    The only means to transport iron ore from the Schefferville area to seaports is by rail. The railway, comprising 565km of track between Schefferville and Sept-Iles and originally constructed by IOC is still available and has been in continuous operation for 50 years. The northern section of the railway from Schefferville to Emeril Junction is now operated by Tshiuetin Rail Transportation Inc. (TSH), a company owned by a consortium of First Nations.

    The TSH section of the track is only now actively hauling LIM's iron ore after operating a service from Schefferville to Sept-Iles for passenger and light freight traffic from the time IOC closed operations. LIM is using this existing railway connection operated by TSH where it then connects to the Quebec North Shore & Labrador Railway (QNS&L) which operates the 360km of rail from Emeril Junction, down to the Port of Sept-Iles. Under Canadian Federal legislation each rail operator is designated as a Common Carrier and is obliged to provide a suitable level of service. LIM has agreements in place with both of these carriers.

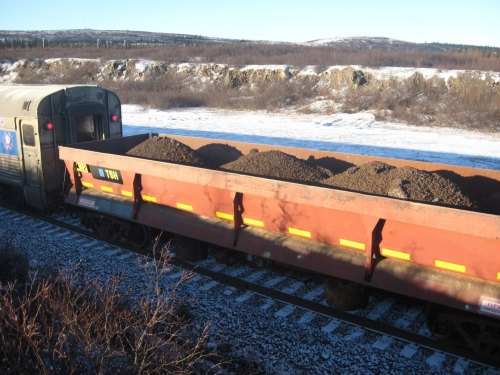

    Infrastructure - Railway

    An independent preliminary study of the TSH railway was carried out for LIM in August 2006 by Hatch Mott MacDonald (Hatch) which concluded that the Menihek Subdivision is in very good condition despite more than 20 years of under capitalization. However, some of the tracks, rails and culverts require refurbishing and a repair and replacement program is recommended to take place over a number of years. LIM is negotiating with TSH regarding freight rate terms for the transport of any ore produced in calendar 2011.

    To support the transfer of the bulk sample iron ore to the Port of Sept-Iles, in 2008 LIM leased ten 90-tonne gondola ore cars and rented five ballast cars from TRTI. The gondola cars will become part of the future leased transport fleet that will include additional ore cars as well as main line and shunting locomotives. In 2008 bulk sample products were successfully transported by rail from Schefferville to Sept-Iles over both the TSH track and track operated by QNS&L. The products that were moved in LIM's bulk sample process and later with the first iron ore rail shipment on June 30, 2011, were the first iron ore shipments to leave the Schefferville area in almost 30 years.

    Deep Seaport

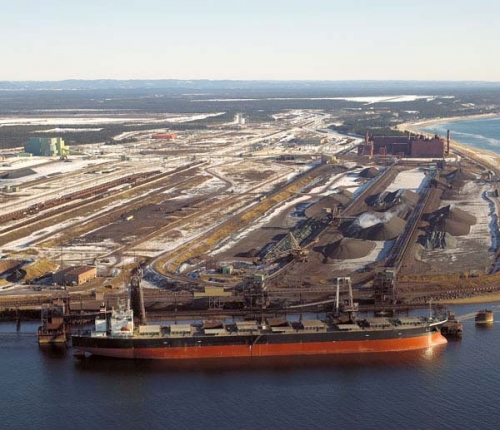

    The Port of Sept-Iles was originally developed for the initial IOC operations in the late 1940's and has continued and grown since that time. Today it exports over 30 million tonnes of iron products annually. LIM has signed a MOU with the Sept-Iles Port Authority for the use of the Pointe aux Basques terminal for handling and ship loading of LIM’s iron ore for the 2011 season and potentially beyond. LIM has also signed an agreement with a port terminal operator for the unloading, stacking and ship loading of iron ore at Pointe aux Basques. LIM will have exclusive use of the Pointe aux Basques terminal for iron ore shipments.

    Corporate - Port
    Vessel Loading at IOC Wharf
